PMI-CPMAI Examination Content Outline (ECO)
The PMI-CPMAI Examination Content Outline, usually shortened to the CPMAI ECO, is the document the exam is written from. It lists the five domains PMI tests, the share of the exam each one carries and the tasks that describe what a capable AI project leader actually does. For candidates preparing for the PMI Certified Professional in Managing AI credential, it is the one reference that settles what is in scope and what is not. This guide reads the outline domain by domain, explains what each group of tasks means in practice and shows how the domains connect.
What Is the PMI-CPMAI Examination Content Outline?
The ECO is PMI’s official specification for the exam. Every exam question maps back to a task in the outline, so a topic that is not in the ECO is not being tested. The document uses three terms that candidates should keep apart:
- Domain: a major area of the exam, each with its own percentage weighting.
- Task: a piece of work an AI project leader performs within that domain.
- Enabler: an example of what doing the task well looks like in a real project.
PMI built the outline from a job-task analysis in which practitioners identified 68 tasks of real AI project work, which were then grouped into the five domains. The ECO describes what is tested; it does not teach it. The eligibility and Exam Prep Course requirements are covered separately and PMI’s official PMI-CPMAI certification page remains the final word if any figure ever differs.

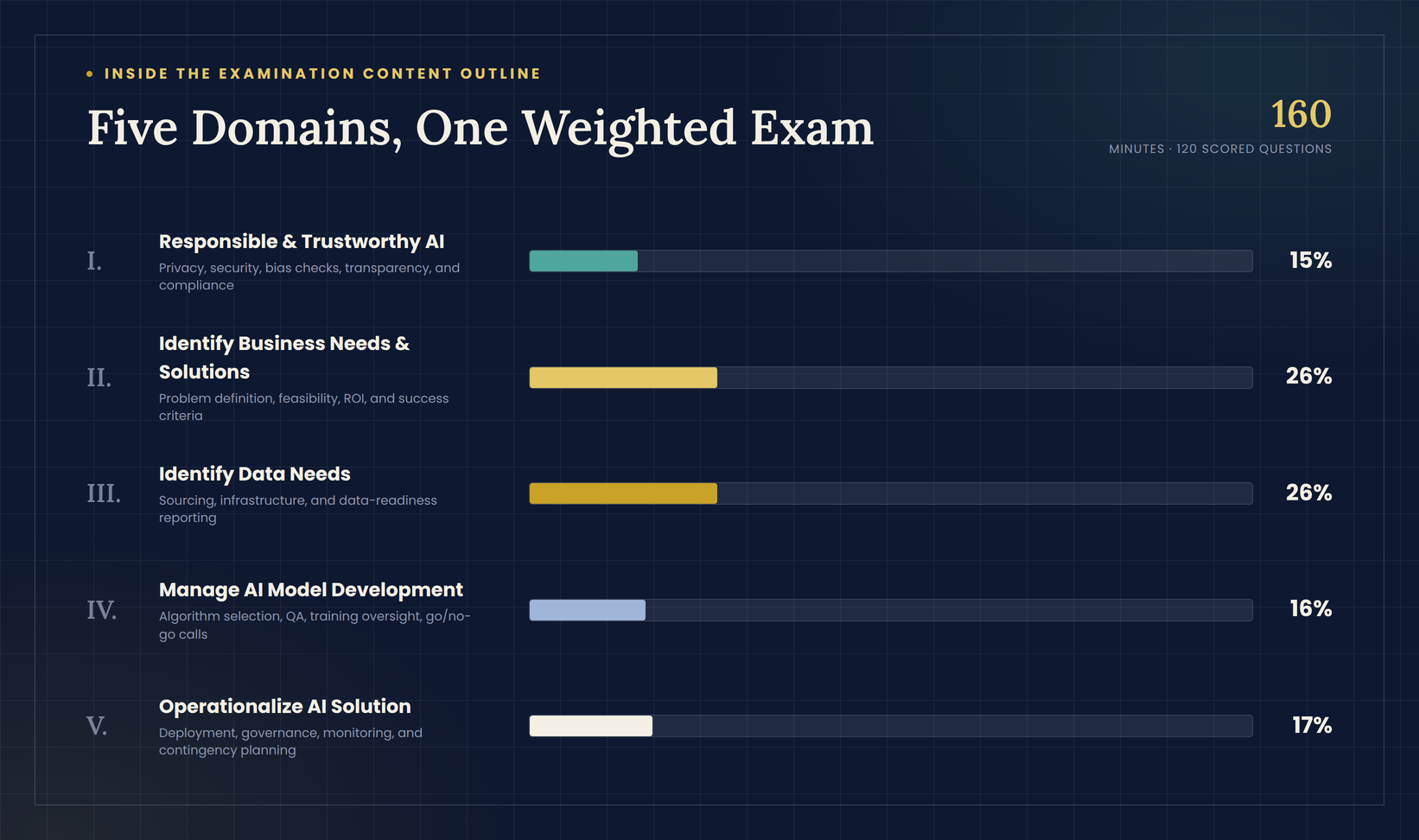

PMI-CPMAI Exam Domains and Weightings at a Glance
Domain Weight Core question it answers
I. Support Responsible and Trustworthy AI Efforts 15% Can this AI be trusted and audited?
II. Identify Business Needs and Solutions 26% Should this be built, and for what value?
III. Identify Data Needs 26% Is there data that is fit for the purpose?
IV. Manage AI Model Development and Evaluation 16% Is the model good enough to move forward?
V. Operationalize AI Solution 17% Can it run, be monitored and be governed once live?
| Domain | Weight | Core question it answers |
|---|---|---|
| I. Support Responsible and Trustworthy AI Efforts | 15% | Can this AI be trusted and audited? |
| II. Identify Business Needs and Solutions | 26% | Should this be built, and for what value? |
| III. Identify Data Needs | 26% | Is there data that is fit for the purpose? |
| IV. Manage AI Model Development and Evaluation | 16% | Is the model good enough to move forward? |
| V. Operationalize AI Solution | 17% | Can it run, be monitored and be governed once live? |
Domains II and III together account for 52% of the exam, which makes the front end of an AI initiative, the business case and the data, the heaviest part of the outline. Question count and exam time are set by PMI and can change, so candidates should confirm them on PMI’s exam page before booking.
Domain-by-Domain Breakdown of the CPMAI ECO

Domain I: Support Responsible and Trustworthy AI Efforts (15%)
This is the smallest domain by weight, yet its themes appear inside scenarios from every other domain. The task areas cover privacy and security planning, transparency of models and algorithms, bias checks on both data and outputs, compliance with regulation and policy, and documentation of accountability.
In practice, a leader asked to approve a résumé-screening model would be expected to ask what data it learned from, who tested it for bias and who answers for its decisions. Questions here tend to reward the answer that adds a control without stopping delivery.
Domain II: Identify Business Needs and Solutions (26%)
The first of the two heaviest domains deals with whether and why an AI project should exist. Its tasks include defining the business problem, evaluating feasibility, assessing risk, scoping the work, calculating return on investment, managing adoption risk and setting success criteria.
A sponsor who asks for “an AI chatbot” has described a tool, not a problem. The task in this domain is to establish the problem behind the request, confirm AI is the right approach and agree how success will be measured before any build begins. Executives who sponsor these projects face the same questions, which is why CPMAI-level skills matter for AI initiative leaders.
Domain III: Identify Data Needs (26%)
Also weighted at 26%, this domain covers everything that must be settled about data before a model is trained. Tasks include defining the data required, locating subject matter experts and data sources, coordinating infrastructure, gathering and evaluating data, and communicating data readiness to leadership.
The last task is easy to overlook because it is a stakeholder task, not a technical one. If a demand-forecasting project has usable history for only two of five regions, the leader’s job is to report that gap and its effect on the plan before training starts. Domain III is about identifying, judging and explaining data, not about writing code to process it.
Domain IV: Manage AI Model Development and Evaluation (16%)
This domain moves into oversight of the technical build. Its tasks include guiding algorithm selection, managing quality assurance and configuration, overseeing training, managing data transformation and making go or no-go decisions on model readiness.
Candidates are not expected to build models, but they are expected to judge results. A model that meets its accuracy target on test data yet performs poorly for one customer segment is a typical case: the leader has to weigh the business success criteria set in Domain II against the technical metrics before approving release.
Domain V: Operationalize AI Solution (17%)
The final domain covers life after the model is built. Tasks include deployment planning and execution, model governance, performance monitoring, lessons-learned reporting, transition planning and contingency planning for AI system failures.
AI behaves differently from conventional software here, because a model can lose accuracy as live data drifts away from the data it was trained on. Monitoring, clear ownership after handover and a fallback plan are therefore part of delivery, not an afterthought.
How the Five Domains Connect
The domains follow the life of an AI initiative: business need (II), data (III), model (IV) and live operation (V), with responsible AI (I) running across all of them. This mirrors the six phases of the CPMAI methodology, although the exam is organised by domain and not by phase. A rough mapping looks like this:
- Business understanding sits mainly in Domain II.
- Data understanding and data preparation sit mainly in Domain III, with data transformation oversight appearing in Domain IV.
- Model development and model evaluation sit in Domain IV.
- Model operationalization sits in Domain V.
- Responsible and trustworthy AI practices apply throughout and are tested directly in Domain I.
The CPMAI framework guide explains the phase view in full, which helps when a scenario question could belong to more than one domain.
Common Ways Candidates Misread the ECO
- Treating domain titles as the content. The titles are headings. The questions come from the tasks and enablers beneath them.
- Reading weights as study hours only. A 15% domain still shapes scenarios in the other four, so it cannot be skipped.
- Reading Domain III as a data science domain. It tests how a leader identifies, evaluates and communicates about data, not how to engineer it.
- Treating the outline as a syllabus. It names the tasks but does not teach them, so a course and practice material are still needed.
Using the ECO Alongside Your Preparation
Once the outline is clear, the next step is turning it into a schedule. The 6-week PMI-CPMAI study plan converts these weightings into weekly targets. The PMI-CPMAI Exam Prep Course is mandatory, and the ECO is the best lens for checking that nothing in it was skipped. Candidates who prefer a guided route can work through the tasks in sequence in PMI-CPMAI live classes led by a PMI Authorized Training Partner.
Final Thoughts
The CPMAI ECO is a blueprint of AI project leadership as much as an exam document. Its five domains trace an initiative from the business case to live monitoring, and its heaviest weighting sits at the start, where the problem and the data are defined. Candidates who read the tasks, not just the titles, and who understand how the domains depend on one another are better prepared for scenario questions and for the real projects the credential is meant to reflect.
Frequently Asked Questions (FAQ)
What is the PMI-CPMAI Examination Content Outline?
It is PMI’s official specification for the PMI-CPMAI exam. It lists the five domains, the tasks within each domain, illustrative enablers and the percentage of the exam each domain carries.
How many domains are in the CPMAI ECO and what are their weights?
There are five: Support Responsible and Trustworthy AI Efforts (15%), Identify Business Needs and Solutions (26%), Identify Data Needs (26%), Manage AI Model Development and Evaluation (16%) and Operationalize AI Solution (17%).
Which CPMAI exam domains carry the most weight?
Identify Business Needs and Solutions and Identify Data Needs each carry 26%, so together they make up 52% of the exam.
What is the difference between a domain, a task and an enabler?
A domain is a major exam area with a set weighting. A task is a unit of work an AI project leader performs within that domain. An enabler is an example of what doing that task well looks like.
Does the ECO replace the PMI-CPMAI Exam Prep Course?
No. The ECO shows what the exam tests, while the Exam Prep Course is a required step that must be completed before the exam can be taken.
Does the PMI-CPMAI exam test coding or model building?
No. The outline focuses on managing AI initiatives, so candidates are expected to guide and evaluate technical work rather than perform it.
Where can candidates find the official CPMAI ECO?
PMI publishes the current Examination Content Outline on its official PMI-CPMAI certification page. If any figure differs from a third-party guide, PMI’s version applies.
